Thinking about how long you’ll have to wait for your new bathroom to be finished? Bathroom renovations in Toronto usually take anywhere from 2 to 4 weeks to complete but the actual time frame really depends on a whole bunch of things like the size of your bathroom, how much work needs doing, the materials you want to use, plumbing, permits, inspections and the contractor’s schedule.
A quick little update might be done in a week or so while a complete remodel with new plumbing, electrical work, custom features or major repairs could take much longer. This guide is going to cover what you can expect in terms of time frames for bathroom renovations, all the different stages involved, common delays you might experience, things to think about when it comes to permits, and some practical ways to keep your project moving along. If you’d like a closer look at our full range of bathroom renovation services, you’ll find everything laid out there.
How Long Does a Bathroom Renovation Take?

Most bathroom renovations actually take around 2 to 4 weeks of actual on-site construction. A tiny bathroom with no layout changes might be done in 1 to 2 weeks, while a full renovation could take 3 to 5 weeks.
But if you’re planning to move plumbing around, change the layout, install custom cabinets or order special fixtures, it will typically take longer. Then there are other factors like planning, ordering materials, getting all the permits sorted and inspections to add in before or during construction.
Bathroom Renovation Timeline by Project Type
The type of work you need done is one of the biggest factors in how long your bathroom renovation will take. Replacing old fixtures is usually faster than ripping out the whole room and starting again from scratch.
Small Bathroom Renovation
If you just need to update a small bathroom with no changes to the plumbing, you’re probably looking at 1 to 2 weeks. That’s when you can usually get away with just replacing the vanity, toilet, flooring, lighting, fixtures, paint or just a few bits of tile.
Of course things can get complex if you need to do a lot of demolition work, fix up any water damage, change out the plumbing or use custom materials.
Standard Bathroom Renovation
A standard bathroom remodel is usually done in 2 to 4 weeks. It might involve a bit of demolition, new plumbing, electrical updates, some waterproofing, new tile, flooring, vanity installation, fixtures, mirrors, lighting and painting.
The actual schedule will depend on things like the size of your bathroom, how long it takes to get the materials you need, how well the different contractors can work together and whether or not you discover any hidden problems when you start tearing things out.
Full Bathroom Renovation
A complete bathroom renovation usually takes 3 to 5 weeks. This kind of project usually means you’re going to be ripping out most of the existing finishes and replacing things like the shower or bathtub, the vanity, the toilet, the flooring, the tile, the lighting and the plumbing fixtures.
If you need to change the layout or fix up any damaged framing or subfloors, that’s going to take even longer.
Bathroom With Plumbing or Layout Changes
If you need to move plumbing around, so you can change the position of your toilet, shower, bathtub, sink or drain, you’ll need to do some extra plumbing work. Sometimes you may need to get permits and pass inspections too.
It’s probably going to take about 4 to 6 weeks for a big renovation that involves a lot of plumbing or layout changes, although some projects might get done sooner.
Custom or Luxury Bathroom Renovation
A custom bathroom renovation with things like custom cabinets, specialty tile, heated floors, custom glass, high end fixtures or other made to order products is going to take 5 to 8 weeks or even longer. Sometimes the materials just take a long time to get here which can delay the construction part of the project. For inspiration on what’s possible, take a look at some of our bathroom renovation ideas.
Bathroom Renovation Timeline Comparison
| Project Type | Typical Timeline | Common Work |
|---|---|---|
| Small Bathroom Renovation | 1–2 weeks | Vanity, fixtures, flooring, paint |
| Standard Bathroom Renovation | 2–4 weeks | Tile, waterproofing, fixtures, electrical |
| Full Bathroom Renovation | 3–5 weeks | Complete remodel and new finishes |
| Plumbing/Layout Changes | 4–6 weeks | Fixture relocation, plumbing, possible permits |
| Custom/Luxury Renovation | 5–8+ weeks | Custom cabinetry, specialty tile, premium features |
Note: These time frames are estimates only. Your contractor should be able to give you a much more accurate idea of how long your project will take after they’ve had a chance to take a close look at your bathroom and the scope of work.
What Affects Your Bathroom Renovation Timeline?

You might be surprised to know that 2 bathrooms of the same size can take very different amounts of time to renovate. It all depends on the amount of work that needs doing, the condition of the space, the materials you choose and the project requirements.
Bathroom Size and Layout
A compact bathroom with an existing layout is likely to take less of a wrecking ball to, fewer materials to buy, and less time spent installing. Larger bathrooms or projects that involve gutting the space and starting from scratch however will require a lot more up-front planning and coordination.
Scope of Renovation
Swapping out a vanity and some flooring is much faster than rebuilding the whole bathroom from the ground up. The more parts you replace, however, the more different tradespeople and installation stages you’re going to have to deal with.
Plumbing and Electrical Work
Messing with plumbing fixtures or adding new electrical circuits, lighting, outlets, or heated flooring can easily add on to the project timeline. You’ve got to get these tasks done before certain walls and finishes can get closed up again.
Material Availability
Different suppliers and manufacturers have different delivery times for things like tiles, vanities, shower systems, and faucets. Realistically, if some vital component is backordered it can bring the whole project to a grinding halt even if everything else is ready to go.
Hidden Problems
When you start tearing into things though – ripping out the old tiles, pipes, etc. – you might find that there’s been more damage done to the subfloor, the framing, or even the plumbing itself than you ever could have imagined. Which means you’ll have to stop and fix that before you can even think about putting in the new finishes.
Permits and Inspections
And then there’s the issue of permits – if you need one you’ll have to add on extra time for the application, the inspections, and the inevitable things they’ll flag that you’ve got to go back and fix. The rules and regulations vary from place to place so it’s hard to give a one-size-fits-all estimate.
Contractor and Trade Scheduling
A bathroom renovation is a big job that often requires a team of different tradespeople – plumbers, electricians, tile installers, drywall pros, and so on. If you don’t schedule the work out properly with each of these guys it’s easy to end up with gaps in the project timeline.
Bathroom Renovation Process: How Long Does Each Stage Take?
A bathroom renovation typically goes through a pretty standard sequence – from planning and demolishing, through to the rough-ins and waterproofing, then tile installation, fixtures, and final cleanup and tidying up. But some of these stages can overlap each other, and a lot of times you don’t actually start one until the last stage of the previous one is done.
Planning and Design
Typical time: 1–2 weeks
This stage includes taking measurements, checking that the layout is still what you want, picking out your fixtures and finishes, coming up with a design and scope of work, and all that. Our guide on how to plan a bathroom renovation covers this stage in more detail.
Trying to make as many major decisions as possible before construction starts really does help reduce the number of changes you’ll need to make later on.
Material Selection and Ordering
Typical time: 1–4 weeks
Tiles, vanities, faucets, toilets, shower systems, lighting, flooring, and all the other individual components that make up your bathroom should be picked out and ordered before they get needed on site.
Some of the custom or special-order stuff may need even more time to arrive.
Demolition
Typical time: 1–3 days
Out go the old fixtures, tile, flooring, vanity, cabinetry and so on. And when that’s done the contractor gets to poke around and see if there’s any water damage, or structural issues, or any other things that need fixing.
Plumbing and Electrical Rough-In
Typical time: 2–5 days
The plumbing and electrical work needs doing before any of the final walls and finishes get closed up. Unless you’re planning on moving some fixtures or adding new electrical bits – which can take longer.
Waterproofing and Surface Preparation
Typical time: 1–3 days
The wet areas need preparing and waterproofing before you even think about laying tile. And of course making sure that the underlying surface is set up right is crucial if you don’t want water seeping in and causing damage.
Tile and Flooring
Typical time: 3–7 days
Installing tile – that’s going to include wall tile, shower tile floor tile, plus any cutting, setting, drying or curing time, and of course grouting.
Large-format tiles, intricate patterns, multiple surfaces or special materials can all make this stage take a whole lot longer.
Vanity and Fixture Installation
Typical time: 2–4 days
This is where the final bits get put in place – the vanity, toilet, sink, bathtub or shower fixtures, mirrors, lighting, accessories – and all the other individual components that make up the finished bathroom. Final plumbing and electrical connections also get completed here.
Final Finishing and Cleanup
Typical time: 1–2 days
And finally, the contractor comes in to do any last little touches – caulking, hardware adjustments, fixture testing, cleanup, and one last check-over to make sure everything is up to scratch.
Overall construction time: A typical bathroom renovation in Toronto takes around two to four weeks on the job site. However – and it’s a big however – don’t forget to factor in planning, material lead times, permits and inspections which can add weeks to the overall project timeline.
What Does a 4-Week Bathroom Renovation Timeline Look Like?

A four week renovation gives you a rough idea of what to expect for a standard bathroom project. However, the actual work can go in all sorts of directions. This can depend on everything from the complexity of the job to how things go with inspections, site conditions, and the materials you’ve chosen.

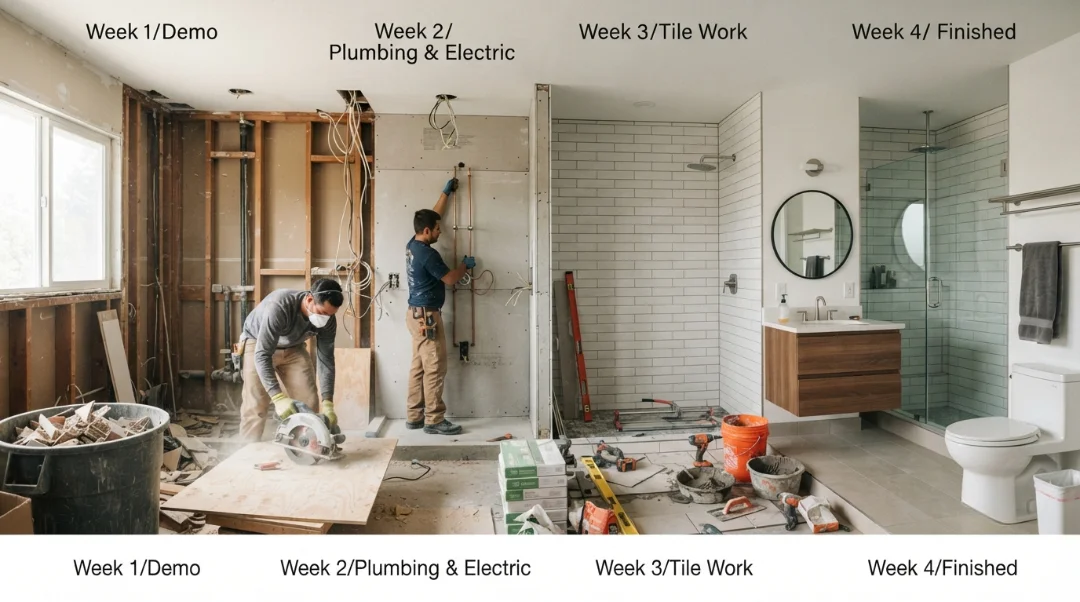

Week 1: Demolition and Rough-Ins
The first week of a typical bathroom renovation usually involves some serious demolition – getting rid of the old stuff – as well as throwing away all the junk, making some framing adjustments, getting the plumbing rough-ins in order, and doing some basic electrical work.
If the layout of the bathroom doesn’t have to change all that much, then this stage can usually move along a bit faster. But if things are more complicated then the repairs can drag the schedule out a bit.
Week 2: Waterproofing and Tile Installation
The second week of the renovation usually focuses on getting everything surface-ready, doing some shower waterproofing and laying down the tile.
Wall and floor tiles get installed according to the approved layout – and then you have to wait for the grouting and setting to dry before you can move on to the next stage.
Week 3: Fixtures and Finishing
At the same time the vanity, toilet, shower or bathtub fixtures, lighting, mirrors, accessories and other major components start getting installed. The plumbing and electrical connections also get completed and tested as the work goes on.
Week 4: Final Details and Handover
By the final week, the focus is on finishing touches like trimwork, installing hardware, caulking, making any last minute adjustments, giving the place a good clean, and making a final inspection.
If you need any inspections then you should schedule them according to the permit requirements for your project.
Planning tip: One thing that’s definitely worth doing is ordering up all the major materials before the construction starts in earnest and finalising your design choices as early as possible. That way you can avoid the stress of having to replace items that haven’t arrived on time or having to redo sections of the job that have already been finished.
Even if you do plan everything to the letter, bathroom renovations can still take longer than you expect. Some delays are just outside the control of the contractor, but a bit of better preparation upfront can help reduce the risk of hold-ups down the line.
What Can Delay a Bathroom Renovation?
Hidden Water or Structural Damage
Old bathrooms can contain all sorts of hidden problems like water-damaged framing, subfloors or drywall – which can take a while to fix before you can get on with the renovation.
Plumbing Problems
Outdated pipes, damaged drains or poor previous installation work can all add extra time to the job.
Material Delays
If major components like tiles or fixtures get held up in the supply chain, it can disrupt the whole project.
Permit or Inspection Requirements
You may need permits and inspections which can delay the start of the renovation, or in some cases the completion of it.
Custom Products
And then there are hand-made components like custom cabinetry, glasswork or specialty tile which can take longer to produce and deliver.
Changes After Construction Starts
Changing your mind on things like the layout, fixtures, colors or even just small details like handles and knobs can add an awful lot of extra work to the project – and cost you a lot of money. For more on what to watch out for, check out our guide to bathroom renovation mistakes to avoid in Toronto.
How Long Will Your Bathroom Be Unusable?
Of course, during the renovation your bathroom may not even be fully available. But how much time you’ll need to go elsewhere will depend on what exactly needs replacing and how the contractor schedules the work.
Shower and Bathtub Downtime
A rough rule of thumb is that the shower or bathtub will be off-limits from the moment demolition starts and won’t be usable again until the waterproofing, tilework, fixtures and plumbing are all finished.
You should plan on being without your shower or tub for anything between 1 to 3 weeks.
Toilet Availability
And as for the toilet – if it’s not being replaced or relocated then it might be okay to use it for a while, but as soon as the plumbing, flooring or installation get underway it’ll need to be shut off until the work is done.
Renovating Your Only Bathroom
If you’ve only got the one bathroom in the house, it’s worth asking your contractor for a clear fixture-by-fixture downtime schedule before construction gets underway. You may need to arrange temporary access to another bathroom during part of the project.
How to Prepare for Bathroom Downtime
Before construction starts on your bathroom renovation:
- Check when the toilet, shower, and sink are going to be out of action so you can make arrangements.
- See if you can use a different bathroom in the meantime, or if you need to find an alternative.
- Get your toiletries and personal items out of the way before the renovators start tearing things apart.
- Make sure you can still get to what you need easily, even with the chaos going on.
- Ask when you can expect the bathroom to be working again.
Bathroom Renovation Permits in Toronto

You’ll need to get a building permit for most bathroom renovations, but this depends on what work you’re having done. The City of Toronto says you need a permit for anything that changes the material of the building or the plumbing system. But, as an example, replacing a toilet doesn’t usually need a permit.
When a Building Permit May Be Required
You should check with the City to see what’s required for your specific project before you start tearing things down. Generally a building permit is needed when you’re changing the layout or structure of the room, for example by adding or removing walls or changing the position of the plumbing.
Toronto has some really useful guidance on this stuff, including how to apply for a permit for interior work and plumbing.
Plumbing Requirements
If you’re having any plumbing or drain work done, there may be extra requirements.
Electrical Work
When it comes to electrical work, you need to make sure it complies with the rules in Ontario, and you may need to get it inspected by the right people.
Condo Renovation Requirements
If you live in a condo, there are probably some extra rules you need to follow, so check with your condo corporation before you start work. They may have their own requirements for things like insurance, working hours, elevator bookings, and contractor access.
How Permits Can Affect the Timeline
If you need a permit, make sure you factor that into your project schedule – starting work before you get the permit can cause delays. And make sure you’re not going to have to stop work while you wait for the permit to come through.
How to Keep Your Bathroom Renovation on Schedule
To avoid delays and last minute changes, get all your decisions out of the way before you start the renovation.
Finalize the Design Before Construction
Confirm the layout, what kind of vanity you want, what shower or tub you’ll be getting, what tile and fixtures you’ll be using, what kind of lighting and flooring you want, and all the other finishing touches before you start demolition.
Order Materials Early
Make sure you get all the major materials ordered in good time, and that you know when they are going to arrive.
Check Product Availability
This is especially important for things like vanities, fancy tile, and plumbing fixtures – you don’t want to be stuck waiting for these things to turn up.
Avoid Mid-Project Changes
Changing your mind after the work has started is a recipe for disaster – it will add to the labour costs and cause delays for other trades.
Confirm the Project Schedule
Ask your contractor to give you a written schedule showing what needs to be done, when they plan to start, what materials they will need, and when they expect the inspections to happen.
Choose One Team to Coordinate the Trades
If several different trades are involved, this is really important to get right – it can save you from weeks of delays.
Why Work With a Professional Bathroom Renovation Contractor?
A bathroom renovation is a lot more complicated than just chucking in a new sink, you need to get the plumbing, electrical work, tile, glass, and finishing work all done in the right order or the whole thing falls apart.
A good renovation contractor can sort all this out for you, and make sure the right people are doing the right jobs at the right time. They can also sort out the materials and the trades, and deal with any issues that come up on site.
Coordinated Trades
If you haven’t got a project coordinator then you need to make sure you have a good system in place to keep all the different trades on track – plumbers, electricians, tile people, and the rest all need to be working at the right stage of the project. If you don’t have a good system in place you could end up with weeks of unnecessary downtime.
Clear Project Scheduling
This will give you a much better idea of when demolition, rough-in work, waterproofing, tile work, installing fixtures and final clean up are likely to happen.
Proper Waterproofing
Waterproofing is a big deal – you’ve got to get it just right before laying tile in any wet areas, otherwise you’re stuck facing costly repairs down the line due to moisture problems.
Material Management
Working with a contractor can help sort out all the materials you need and get them delivered at just the right time, so your project stays on track.
Quality Checks
Regular check-ins during construction can actually pay off big time by spotting installation problems before they’ve become a huge pain to sort out.
Why BathBuilt Has Been a Homeowner Favorite Since 2018?

For homeowners in the Toronto area looking to revamp their bathrooms, BathBuilt has got you covered – they provide bathroom renovation services that span design, construction, waterproofing, tile installation, plumbing, electrical work, fixture installation and finishing.
The company works all over Toronto and the GTA, and can take on bathroom renovation projects of all shapes and sizes.
Complete Bathroom Renovation Services
BathBuilt can handle every aspect of your bathroom renovation – from custom designs to walk-in showers, bathtub installation, bathroom vanities, tile installation, waterproofing, flooring, lighting, plumbing and electrical work.
Coordinating all the different elements of a renovation through one company can make life so much easier when it comes to scheduling.
Project Management
BathBuilt is upfront about how they handle bathroom renovations – they assign dedicated project managers to take care of trades, materials, scheduling, installation and the final project details.
Waterproofing and Tile Installation
Waterproofing is a critical stage of any bathroom renovation because, let’s face it, you can’t put tile and other finishes in the bathroom without first protecting it from moisture.
BathBuilt has got all the services you need to get bathroom waterproofing and tile installation done – including options like Schluter® waterproofing systems, porcelain tile, ceramic tile, large-format tile and natural stone finishes.
Toronto and GTA Service Areas
BathBuilt serves up bathroom renovation services to homeowners all over Toronto and the GTA – that’s all sorts of neighbourhoods like North York, Etobicoke, Scarborough, Vaughan, Markham, Richmond Hill, Thornhill, Mississauga, Brampton, Aurora, Newmarket, Pickering, Ajax, Whitby, Oshawa, Milton, Burlington and Oakville.
Conclusion
A typical bathroom renovation in Toronto can take anywhere from 2 to 4 weeks of actual construction work – but that can vary significantly depending on the scope of the job.
Planners who get ahead of the game by getting their design sorted early, ordering materials on time and working with a contractor who can handle all the different trades will find their renovation stays on track. And if you’re planning a bathroom renovation in the Toronto or GTA area, BathBuilt has got the expertise to help manage your project from planning to final installation and finishing. Get in touch with us to talk through your project.
Plan Your Bathroom Renovation with Bathbuilt in Toronto & GTA

A typical bathroom renovation can take anywhere from 2 to 4 weeks to complete, but every project is different – the size of the space, the materials you choose, plumbing changes, custom materials, permits and all sorts of other factors can all add up to extend the timeline.
The key to avoiding nasty surprises? Plan your layout and materials early, get all the permits you need and get a clear construction schedule nailed down before the demolition begins.
If you’re planning a bathroom renovation in the Toronto or GTA area, BathBuilt is there to help you coordinate the whole thing, from planning through to installation and final finishing. Learn more about our team or browse our full bathroom renovation services to get started.
Frequently Asked Questions About Bathroom Renovation Timelines
-
How Long Does a Bathroom Renovation Take in Toronto?
A typical bathroom renovation in Toronto will take around 2 to 4 weeks of actual construction. But smaller updates might just be done in 1 to 2 weeks, while full renovations with plumbing changes, electrical work, custom materials, permits or structural repairs are going to take a lot longer. And that’s before you even start planning and ordering the materials which can add a bit more time before you can even start hammering nails.
-
How Long Does a Small Bathroom Renovation Take?
A small bathroom renovation usually takes about 1 to 2 weeks if you’re not changing the layout and plumbing are all good to go. Replacing a vanity, toilet, flooring, tiles and fixtures is generally a pretty straightforward process and doesn’t take too long at all. But on the other hand, you’ve got deals like waterproofing repairs, a lot of demolition work, custom products, or hidden damage that can just throw off the timeline.
-
How Long Does a Full Bathroom Renovation Take?
A full bathroom renovation will generally take 3 to 5 weeks from start to finish – from the day we start ripping stuff out to the final touch ups. A full renovation would include new tile, waterproofing, flooring, vanity, toilet, shower or bathtub, lighting, plumbing and electrical work. Of course, all those layout changes, structural repairs, custom features and material delays can all extend the completion date.
-
How Long Does a 3-piece Bathroom Renovation Take?
A 3-piece bathroom renovation usually takes about 2 to 4 weeks, depending on just how big a job you’re doing. If you’re just swapping out the fixtures and keeping the existing layout pretty much intact, you can probably get in and out pretty quickly. But on the other hand, a full remodel involving demo work, waterproofing, tile, flooring, plumbing, electrical work, vanity installation, and new fixtures is just going to take a lot longer.
-
How Long Does a 4-piece Bathroom Renovation Take?
A 4-piece bathroom renovation is going to take around 3 to 5 weeks, depending on just how big the bathroom is and how much scope of work you’ve got lined up. If you’re replacing a bathtub or shower, toilet, vanity, flooring, tile, lighting, and fixtures – you’re looking at several installation stages. And then you’ve got plumbing relocation, custom features, material delays, or repairs that can all just add more time.
-
Can a Bathroom Renovation be Completed in 2 Weeks?
Yes, some bathroom renovations can get done in about 2 weeks. And that’s usually when you’ve got a simple layout, plumbing locations are all unchanged, and all the materials are available before we even start. But a full renovation with all the plumbing changes, custom work, or structural repairs is just going to take more time.
-
How Long Will I be Without a Shower During Renovation?
For most bathroom renovations, the shower or bathtub is going to be out of commission for about 1 to 3 weeks – or sometimes a bit longer. All depends on the extent of the demo work, plumbing changes, waterproofing, tile installation, cure time, fixture installation, and final testing. Your contractor should give you a good idea of what to expect before we even start.
-
Do Permits Make a Bathroom Renovation Take Longer?
They can. If your project requires permits, you’ve got to factor in application, review, and inspection time. Toronto’s permit requirements vary depending on just what kind of work you’re doing so it’s always best to check if your specific renovation needs a permit before we even start.
-
What is the Biggest Cause of Bathroom Renovation Delays?
It’s material delays, hidden water damage, plumbing problems, permit requirements, trouble with getting the trades to show up on time, and all the changes that get made during construction. To avoid all these problems, we recommend ordering materials early, finalizing the design before we start demo work, and making sure your contractor knows how to coordinate all the trades involved.
-
How Do I Get My Bathroom Renovation Finished Up Quicker?
Get your design sorted out as soon as possible, order all the materials before the demo crew comes knocking, make sure you double check that all the right products are actually in stock, try to avoid those last-minute design changes when all the walls are already torn out, and take care of all the permits before the renovation even gets started. And, if you can, try to attach yourself to a contractor who’s managed projects like this before and has all the right people on speed dial – someone who can sort out the plumbing, the electrical, the waterproofing, tiling, fixtures and finishing all at the same time so you don’t get hung up waiting for one bit before another can be completed.
